Bramford Solar Farm
On this page you will be able to find key contact information and project updates.

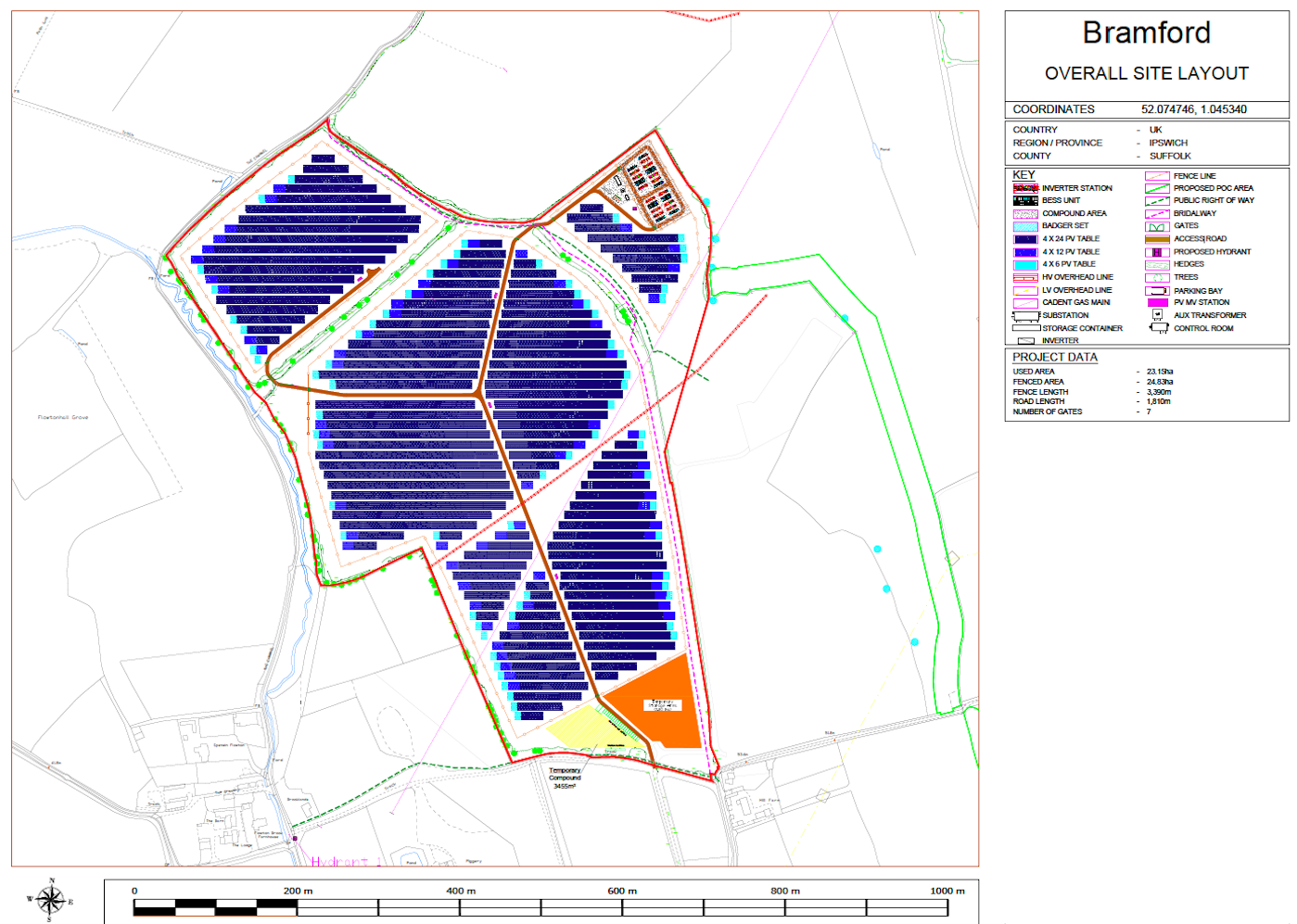

Construction Routing Map
We have recently moved into the main construction phase for Bramford Solar Farm located on land near Burstall Hill, Burstall, Suffolk.
Since December 2025, the contractor have established their temporary welfare and site laydown areas. From February through to March 2026, construction of the site roads will begin, followed by installation of the solar array piles, and initial works on the battery foundations.
Verdant Energy will deliver Bramford Solar Farm and Battery Storage through the construction phase and into operations. Verdant Energy brings decades of experience in project development, delivery, and operations of renewable projects across the UK and abroad.
The Solar Farm will be connected into the local electricity network. This will power the equivalent of 10,600 homes and displace 4,660 tonnes of CO2 every year it is in operation.
The battery storage will provide power for over 80,000 homes for a duration of 2 hours, multiple times per day.
To keep the community informed and involved we held a Public Information Event on Tuesday 15th July 2025 at Burstall Village Hall.
Engagement with the Community
Online Form
Please feel free to get in touch with us using the online form on the right-hand side.
We believe that it’s right that the community closest to a solar farm is able to benefit from it. In addition, we believe that the community itself is best placed to say what the community benefit should be. If you have an idea for a sustainable community-based scheme or project, then please share your idea with us.
Community Liaison Group
The project team holds a Community Liaison Group meeting with representatives every month. Please find the minutes for the meeting below -
Contact Information
General Enquiries Emergency Contact
Cem Sabri - Communications Lead Patrick Futter - Site Manager
0800 707 4146 07398 132 829
contact@bramfordsolarfarm.co.uk patrick.futter@belectric.com
WhatsApp Group
We are keen to keep residents informed throughout the entire construction process. If you would like to receive further updates, please complete the form on the right and we can add you to the Bramford Construction WhatsApp group.
Indicative Timeline
Site Preparing & Groundworks | January - March 2026
Access Tracks
Perimeter Fencing
CCTV
Foundations for ancillary buildings
Array Framework Installation | March - June 2026
Strong and durable frames made from high-quality materials are installed which are designed for specific climate and weather conditions at the site.
Expert technicians use specialised equipment to drive the frames into the ground
Solar Panel Array Assembly | April - July 2026
Solar panels are placed onto the frames and securely fastened
Panels are position to ensure optimal exposure to the sun
Technicians ensure proper spacing and alignment between the panels and frames
Final checks are performed to ensure panels are functioning properly and securely mounted
Battery Energy Storage System (BESS) & Connection Equipment | April - July 2026
Ground preparation and sustainable drainage provided for the BESS and connection equipment.
Prefabricated Battery, PCS and MV Twin skid Units are installed along with a “customer substation” switchgear unit.
Cables connect the inverters and the BESS technology to the switchgear unit which will then be connected to National Grid infrastructure.
Testing and Commissioning | July - August 2026
Final testing of solar farm equipment and systems
Connection of solar farm to the electrical grid
Landscaping (According to Planting Season) | Late 2026 - Early 2027
Seeding and planting of site and boundaries
Implementation of a custom planting plan
Planting at the next suitable opportunity if outside of ideal planting seasons
